General Conditions in Construction | The Takeoff AI
What general conditions cover in a construction estimate, how they differ from overhead and general requirements, and how to estimate them from job duration.
Industrial contractors often call these field indirects. The costs are the same, only the name differs.

How to Estimate General Conditions
General conditions are easy to underestimate because nothing on the drawings shows them. The reliable way to build them is to tie each cost to what drives it, which for most lines is time on site.
Set the Job Duration
Work out how many weeks the project runs, from the labor hours in the takeoff, the crew size and the schedule the owner has set.
Split Time-Driven From Fixed Costs
Supervision, trailers, equipment rental and site services cost a set amount per week. Mobilization, demobilization, permits and setup are paid once.
Price Each Line
Multiply the weekly costs by the duration, add the one-time costs, and check the total against what similar jobs carried.
What Goes Into General Conditions

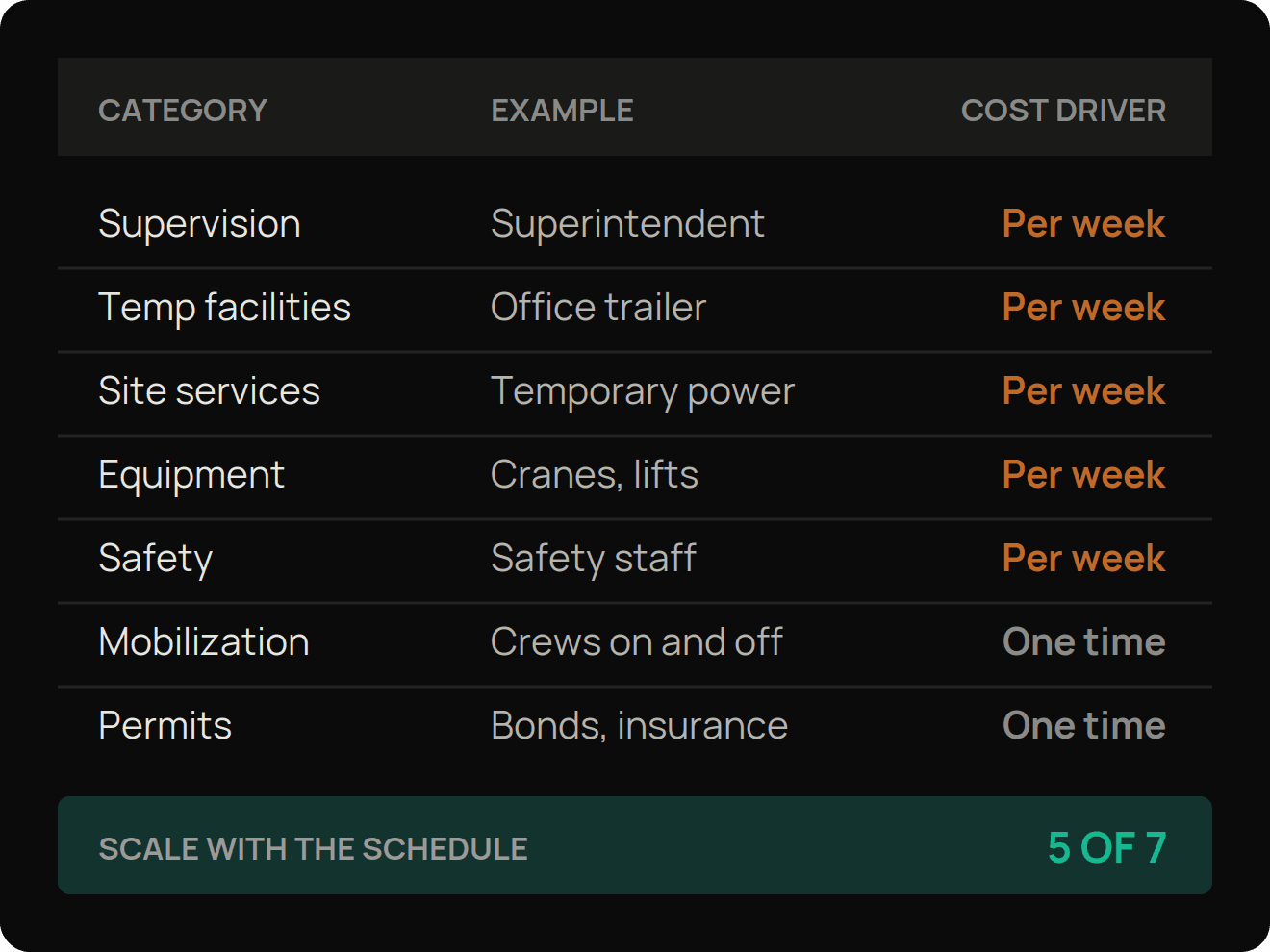

The list changes with the job and the contract, but the same categories come up on almost every project. Sorting each line by its cost driver shows which costs will move when the schedule slips, and on most jobs that's the majority of them.
- Supervision and project staff, usually the largest line
- Temporary facilities, utilities and site services
- Equipment, safety and one-time mobilization costs

Why General Conditions Start With the Takeoff
Most general conditions are priced per week, so the whole line rests on how long the job runs, and the duration rests on the labor hours in the takeoff. If the takeoff misses material, the hours come in short, the schedule comes in short, and the general conditions come in short along with it.

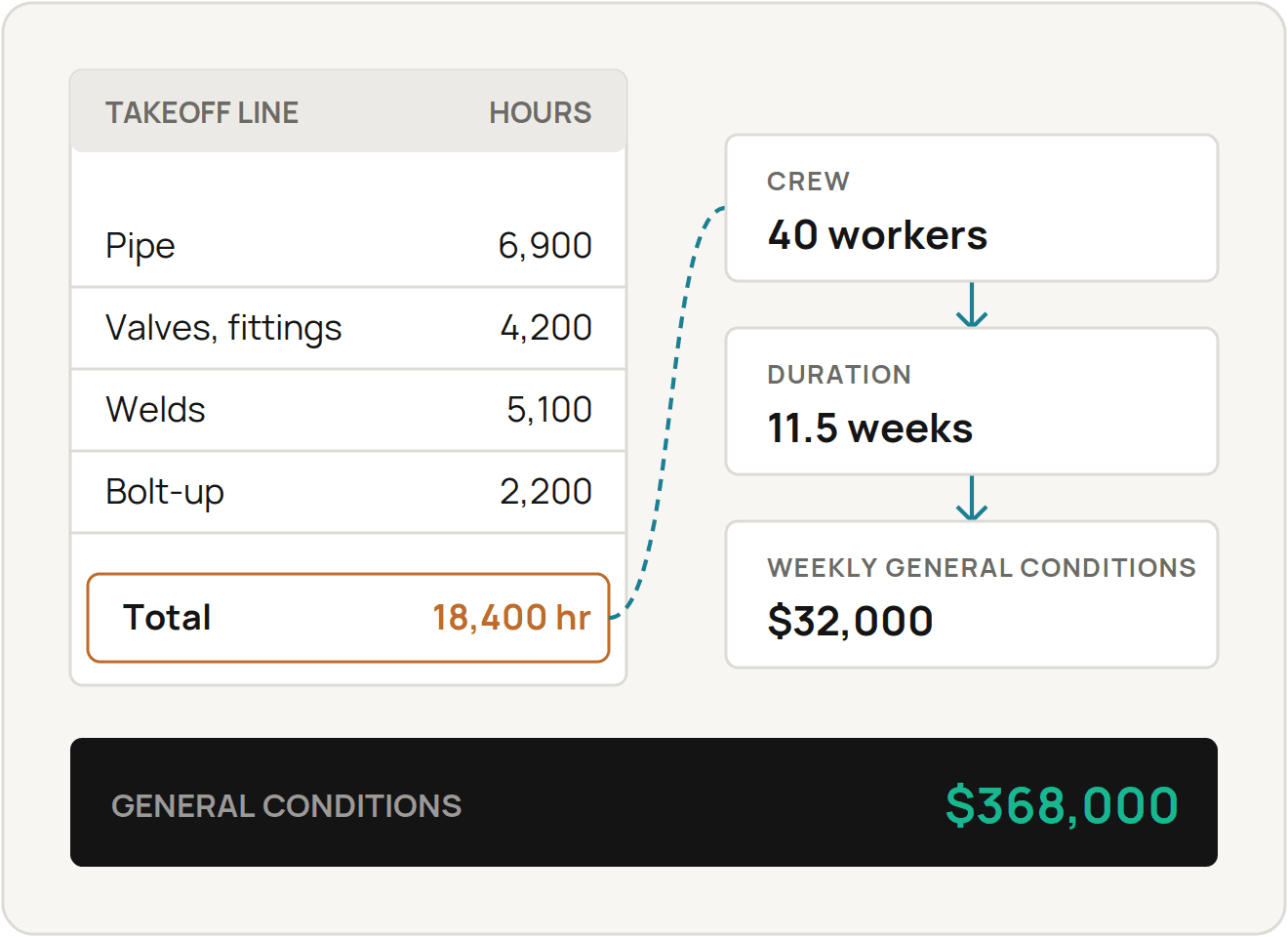

The Takeoff AI builds the full material takeoff from the package, including items the spec requires but nobody draws, and prices labor off your own rates. That gives you a labor-hour total you can trace line by line, which is the number your duration and your general conditions are built on.
- Labor hours traced back to every line of the takeoff
- Priced off your own labor rates

Schedules Are Tight and Every Extra Week Costs Money

Owners are pushing compressed schedules, and each week a job runs past plan adds a full week of supervision, rentals and site services. Estimators who tie general conditions to a defensible duration protect the margin that a flat percentage quietly gives away.
General conditions are only as accurate as the duration behind them.
